Outagamie County, Wisconsin, USA

STH 96, west of Appleton, WI

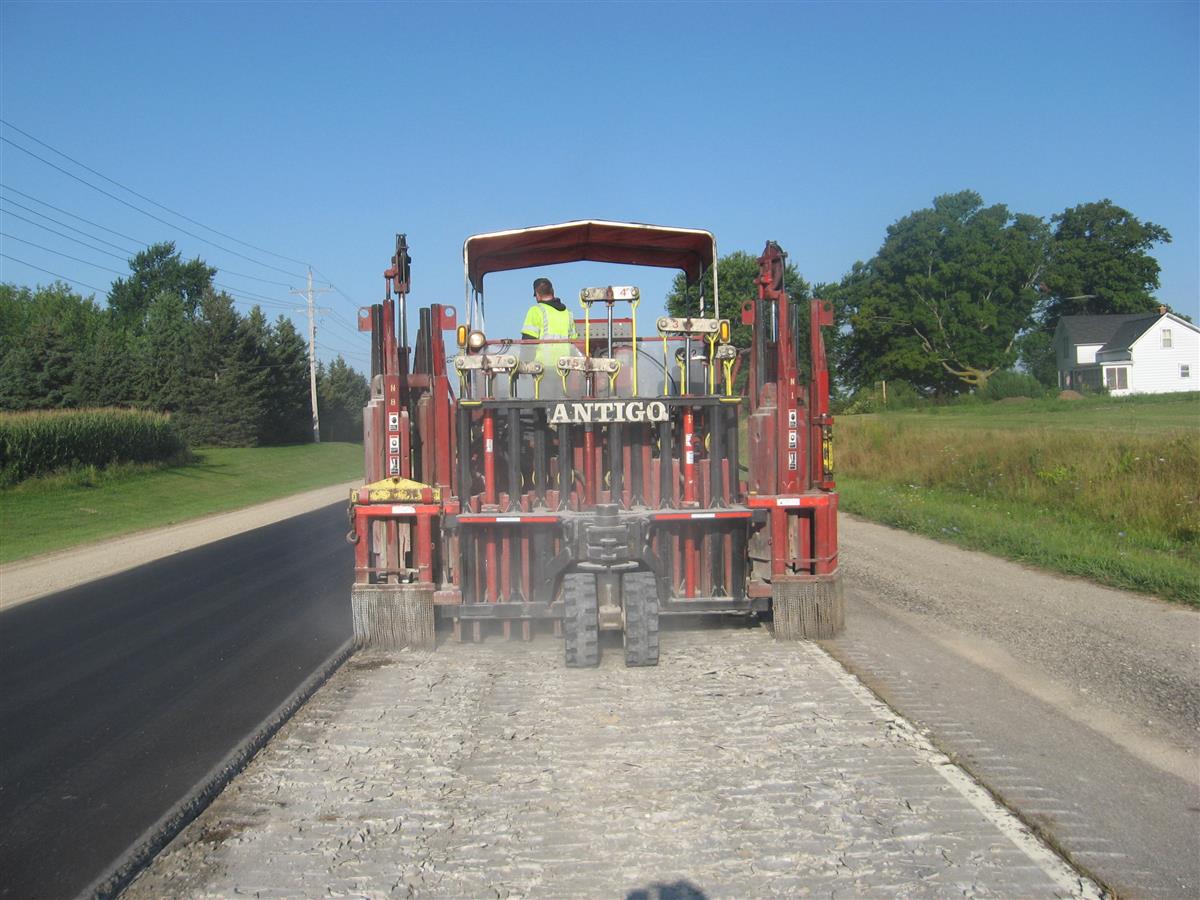

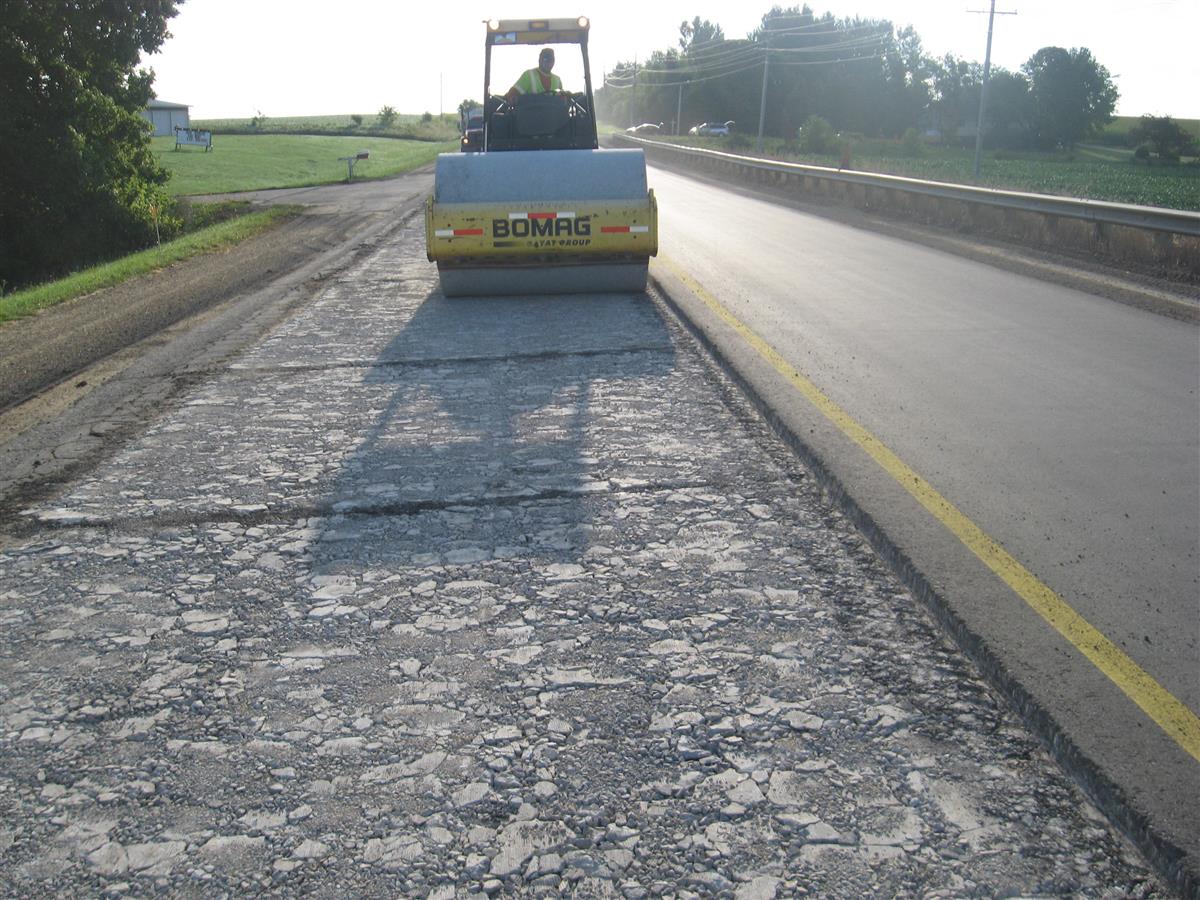

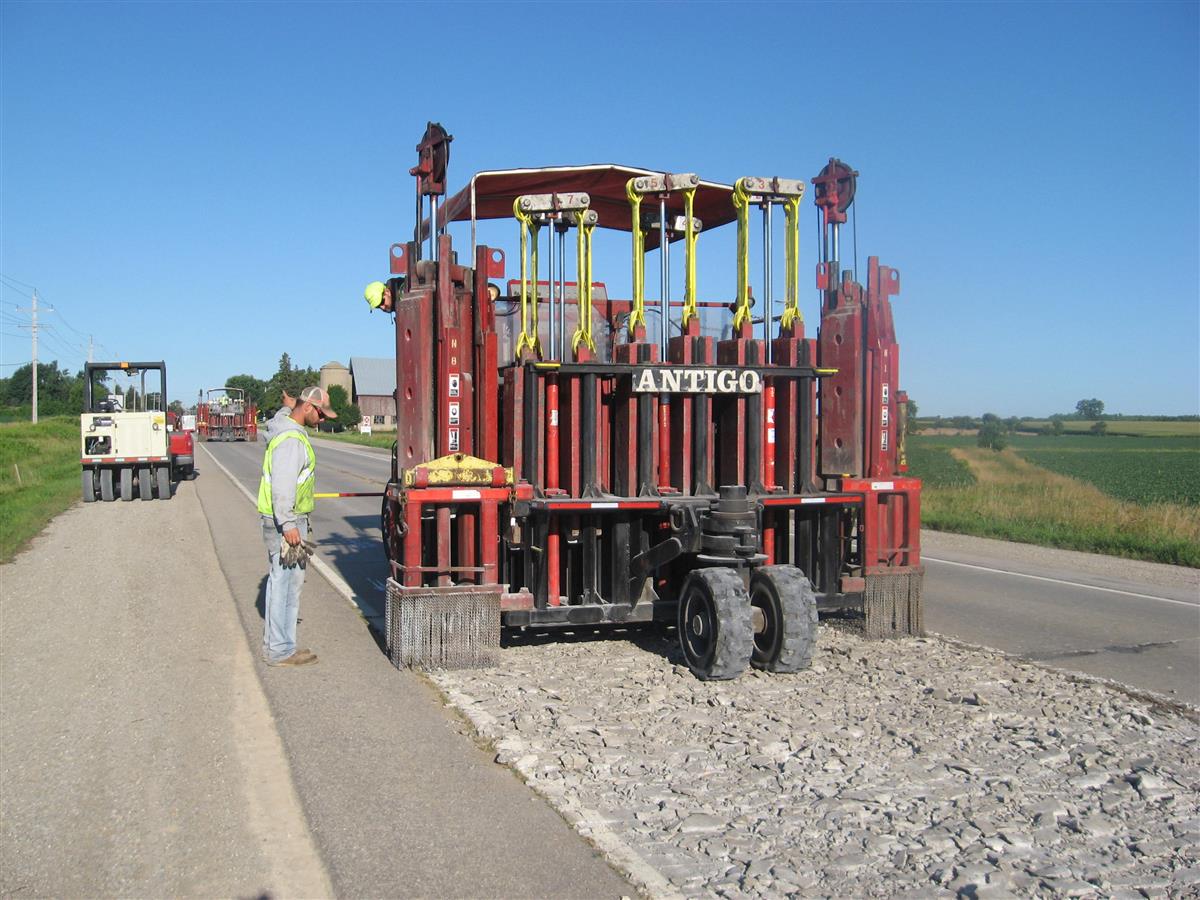

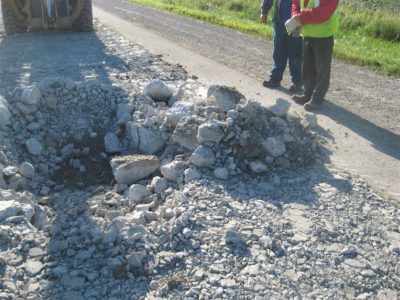

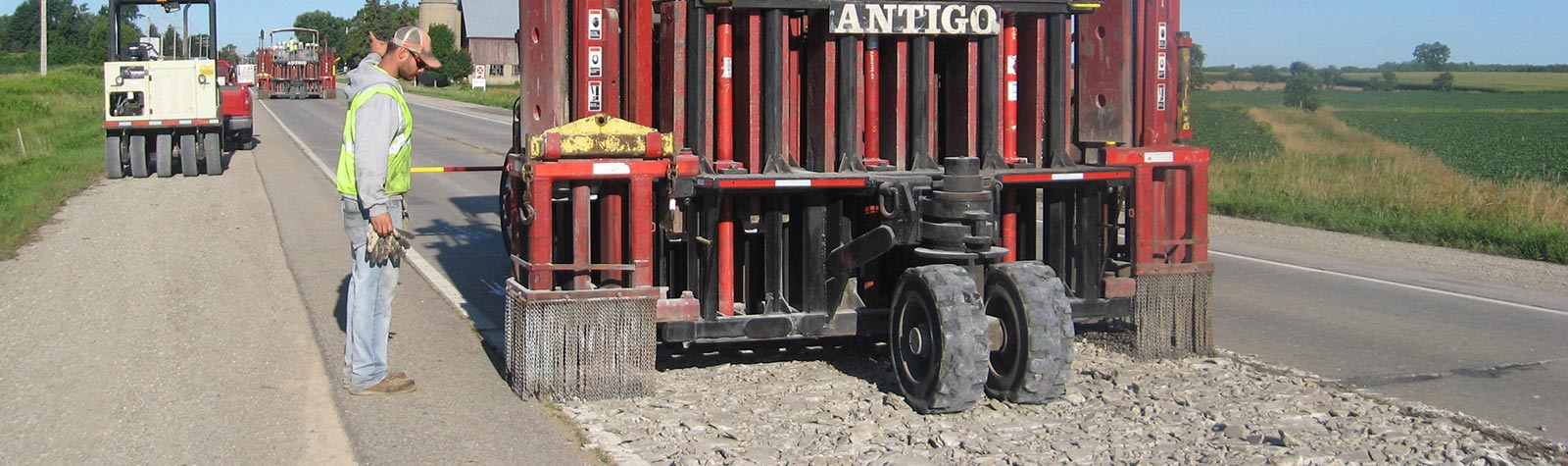

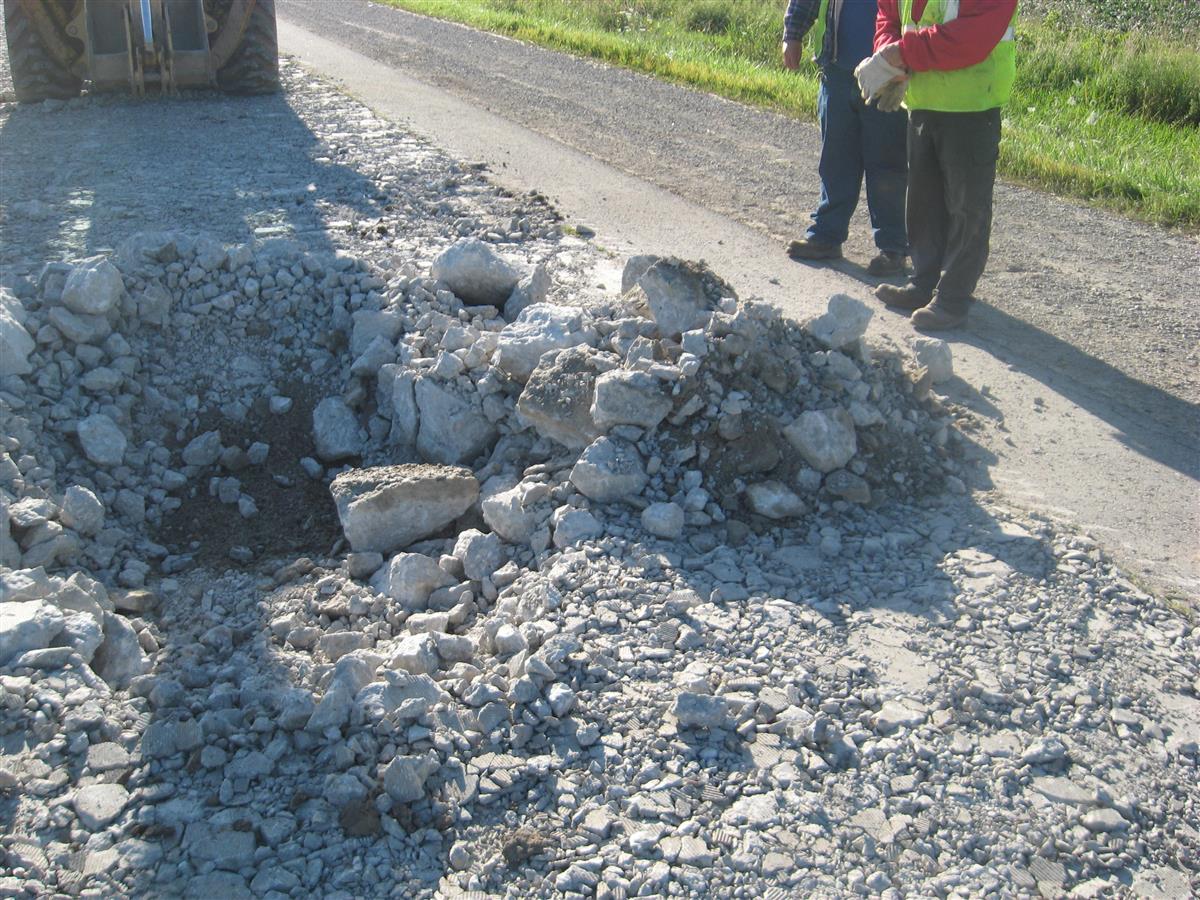

Rubblized 112,000 square yards of concrete pavement in only 9 shifts. Operated 2 MHB Badger Breakers® starting early in the morning and working for approximately 8 hours. The paving crew started two hours after the MHBs started and had all of the rubblized pavement covered with asphalt by the end of the day. A modified rubblization pattern was used due to low subgrade support.

View Rubblization Media

Project Details

Location

STH 96, west of Appleton, Outagamie County, Wisconsin, USA

Existing Pavement

9" thick JPCP

New Pavement

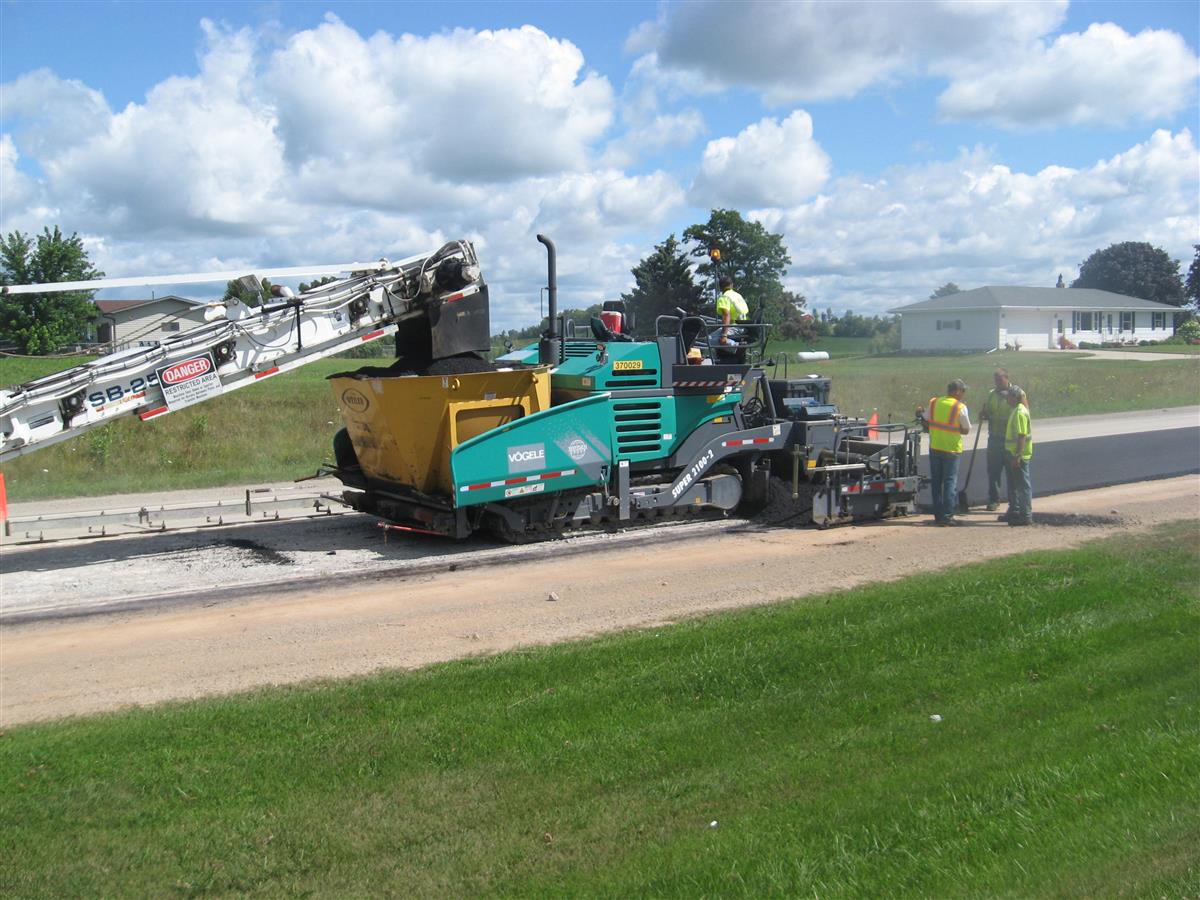

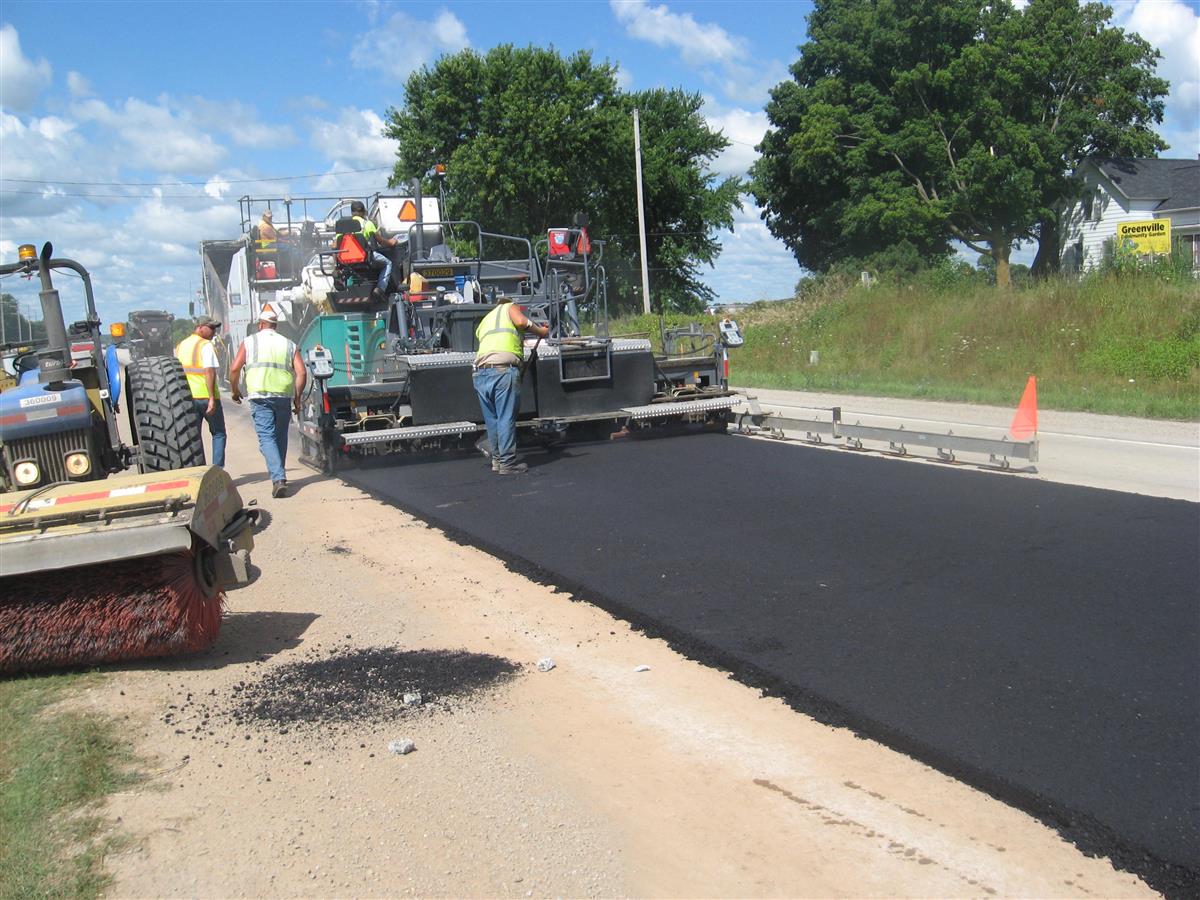

5" thick asphalt overlay

When

Summer, 2013
